Yes, you can replace an industrial roof in Tulsa without stopping the whole plant.

We do it by splitting the roof into zones, tying each zone to the work below it, and closing each section before the shift ends.

The main goal is simple: protect production time, not just control roof cost.

Here’s the short version:

  • Plan roof work around the plant schedule
  • Match each roof zone to one bay, line, or department
  • Protect product, equipment, and air systems below open areas
  • Coordinate HVAC, vents, docks, and shutdowns before tear-off
  • Pick the right work window: day shift, night/weekend, or full shutdown
  • Set access routes, staging space, and one approval contact before work starts
  • Use the right membrane for the building, with TPO as the usual choice

A roof leak can cost far more than the roof itself if it hits product, slows shipping, or puts equipment at risk.

In many plants, even 1 to 2 hours of lost production can outweigh a big part of the project budget.

The hard part is how to do it.

We keep it under control with tight phasing, dust and debris control, daily shutdown checks, and zone-by-zone scheduling. Long-term reliability is then managed through commercial roof maintenance plans.

If you need a fast snapshot, start here:

Focus AreaWhat matters most
Production uptimeKeep most lines running while work moves by section
Live-floor protectionControl dust, debris, moisture, and fasteners
Equipment planningTime HVAC, exhaust, vents, and dock access before each zone opens
Work windowChoose day shift, off-shift, or shutdown based on plant limits
Pre-job planningLock in access, staging, contacts, and phase sign-off
Membrane choiceTPO for most jobs; PVC or EPDM for certain conditions

In other words: the roof gets replaced, and your plant keeps moving because the sequence is built around your floor – not our crew.

Commercial Warehouse Metal Roof Damage

Working above a live floor: containment and protection first

If your floor stays live, each tear-off zone has to protect the work below.

That’s why we map the roof plan to the floor layout before tear-off starts.

Debris control and fastener control are non-negotiable from day one.

Old membrane, insulation scraps, and dust can contaminate product, packaging, and fixed equipment.

Each opened zone should be sealed back up before the shift ends.

If weather threatens, secure the area with a temporary cover.

What happens under active tear-off areas

Before tear-off starts in any zone, identify sensitive products, packaging, and fixed equipment.

Then protect them, move them, or isolate them.

Keep forklifts and other vehicles out of the active zone until it is sealed.

Check ceiling-mounted systems below the active zone before and during tear-off.

HVAC units over active work zones should be shut down during the shift so they don’t pull dust or moisture into the facility.

New white membrane roof with rooftop equipment during a commercial roof replacement on East 54th Street in Tulsa, OK

How the roof plan connects to floor activity

The roof schedule should match the floor schedule.

If a bay handles sensitive work, schedule that area around planned downtime or off-shifts.

If a dock needs to stay open for shipping, don’t block it with crane placement or material staging.

Mapping roof zones to your production layout is how we set the project sequence.

Storage lanes, production cells, docks, and maintenance corridors all shape which roof section gets opened on which day.

Then we match each roof zone to the production area below it.

From there, we phase the work by bay and by equipment, not by crew convenience.

Commercial Warehouse Metal Roof Inspection

Phase the project by bay and by equipment, not by crew convenience

Once the roof zones line up with the floor layout, phase the job by bay and by equipment.

That way, each roof zone ties to one production area and one equipment plan.

It keeps the work tighter.

And it cuts down on spillover into parts of the plant that don’t need to be touched.

Map roof zones to production areas

Match each roof zone to the space below it.

The goal is simple: only one department is exposed at a time.

When a zone maps cleanly to one production area, it’s much easier to control dust, noise, access, and downtime.

Worker crossing the new white membrane roof during a commercial roof replacement on East 54th Street in Tulsa, OK

Rooftop equipment drives the sequence

In many cases, the rooftop equipment sets the order of work.

HVAC and make-up air units, exhaust fans, dust collection systems, and process vents often need shutdowns or close coordination before work starts in that zone.

Some units must be shut down before tear-off.

Others need a timed restart after the zone is sealed back up.

That’s where internal coordination matters.

Bring in facility, operations, maintenance, and safety staff early for decisions on shutdowns, restarts, access, and daily checks.

Crew staging roofing materials at the roof edge of a commercial roof during a replacement on East 54th Street in Tulsa, OK

Coordination table for common rooftop systems

Use this table to match each system with the shutdown, bracing, or access steps it needs.

Equipment TypeCoordination NeededWho Is InvolvedApproval Needed
HVAC / Make-up Air UnitsShutdown to block moisture or debris, and seal intake vents.Facility Manager / HVAC TechYes (Restart)
Exhaust FansTemporary shutdown during membrane application.Operations ManagerYes (Shutdown)
Dust Collection SystemsCoordination of vibration-sensitive work; temporary duct bracing.Maintenance SupervisorNo
Process VentsCoordination with active production cycles; fume control.Production / Safety ManagerYes (Both)
Fire Sprinkler SystemsDaily debris inspection below open zones; temporary shielding of heads.Safety OfficerYes (Daily Check)
Loading DocksCrane positioning and bay closure scheduling.Logistics / Shipping ManagerYes (Access)

With the sequence set, the next call is how each zone will run: during production, off-shift, or during a planned shutdown.

Choose the right work window: active production, off-shift, or planned shutdown

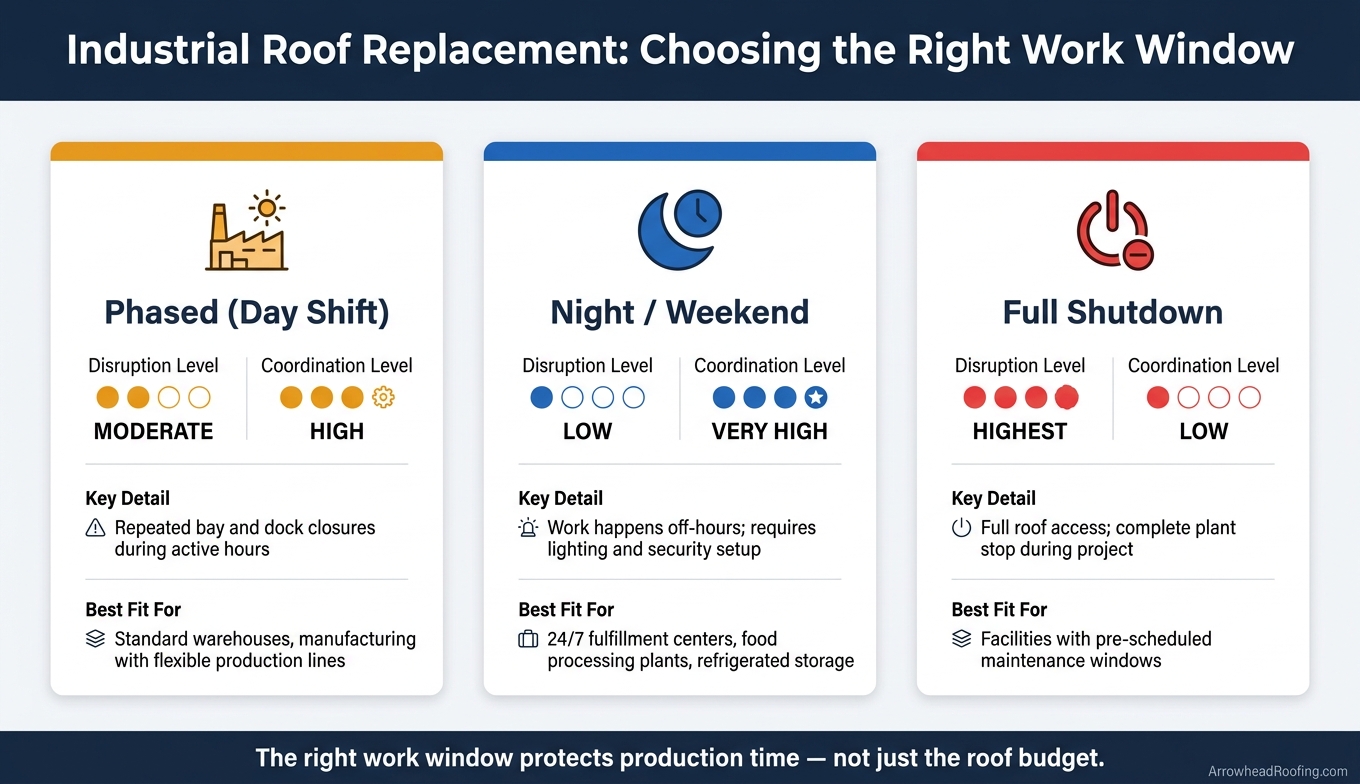

Industrial Roof Replacement: Work Window Options for Active Plants

Industrial Roof Replacement: Work Window Options for Active Plants

Once we’ve mapped the bays and rooftop equipment, the next step is simple: decide when each zone can open.

Fumes, odor, and air intake coordination

Any HVAC unit above an active work zone needs to be shut down before tear-off starts in that zone.

If it stays on, it can pull dust, moisture, and fumes into the building.

That’s a headache you want to avoid.

Solvent-based adhesives used in some adhered membrane systems can create stronger odors in hot weather.

And that can shift the work window.

In practice, we may need to handle those zones early in the day or during off-shift hours to help keep odor lower inside the plant.

Get approval for each HVAC shutdown before work starts.

HVAC unit on a commercial flat roof

When off-shift work makes sense

Off-shift work tends to fit best when a zone sits over a 24/7 fulfillment line, a food production plant with rolling shifts, or refrigerated storage where daytime disruption just won’t work.

Phasing options compared

Use the comparison below to match the work window to your plant’s access limits.

ApproachDisruptionCoordinationBest Fit For
Phased (Day Shift)Moderate; repeated bay and dock closuresHigh; requires daily coordinationStandard warehouses, manufacturing with flexible lines
Night / WeekendLow; work happens during off-hoursVery high; requires lighting and security24/7 fulfillment, food processing, refrigerated storage
Full ShutdownHighest; full access, full stopLow; full roof accessFacilities with scheduled maintenance windows

Before work starts, we need access, contacts, and equipment schedules.

Pre-job checklist and membrane choice for Tulsa industrial roofs

Before we open the first bay, we need three things locked in: the access plan, shutdown contacts, and the equipment schedule.

Our commercial roofing page walks through our commercial services.

And our commercial roof replacement page shows how we handle replacement work on active plants.

What we need from your team before work starts

A clear pre-job plan keeps roof work lined up with your daily operation.

Here are the basics we need before mobilization:

  • Access route for equipment and materials that won’t block loading docks, fire lanes, or employee parking
  • A staging area for material deliveries, palletized insulation, and waste containers
  • Lockout/tagout contact for HVAC units, exhaust fans, and rooftop electrical systems above the work zones
  • Equipment schedule that shows which units can shut down and when
  • One point of contact for weather changes or surprise substrate conditions
  • The person who signs off on each phase before we move to the next zone

Before each shift, your facility manager and our foreman should confirm the active zone, lockout status, and any floor changes below it.

Once the site plan is set, membrane choice comes next.

Worker with tools on the new white membrane roof during a commercial roof replacement on East 54th Street in Tulsa, OK

Membrane options: a short list and where to read more

TPO is the default membrane for us and makes up the large majority of our commercial work.

MembraneBest fit
TPODefault membrane
PVCFacilities with chemical exposure, grease, or animal fat in the exhaust stream
EPDMCold-climate or ballasted assemblies

If you want a closer look at TPO, see our commercial TPO roofing page.

For a side-by-side comparison, read our TPO vs. EPDM vs. PVC guide.

FAQs

Can you replace our roof without stopping production?

Yes. Replacing an industrial roof while production continues takes a phased plan.

We work with your team to map out the job, set zones, and keep disruption as low as possible.

The idea is simple: break the project into smaller, manageable areas.

That way, each section is dried in and protected before we move to the next one.

In other words, we don’t tear off the whole roof at once.

We move zone by zone so your site can stay up and running with less mess, less downtime, and less risk from weather.

How do you protect product and equipment during tear-off?

We take a phased, well-planned approach to keep your Tulsa operation up and running during an industrial roof replacement.

That means we split the job into manageable zones, dry in and secure each section before we move on, and work with your team around shipping schedules and day-to-day facility activity.

Request a free inspection to get started.

What do you need from our team before work starts?

We use a phased approach to keep production running during an industrial roof replacement.

The work is split into manageable zones and finished one area at a time, so parts of your facility that aren’t affected can stay in use.

We also work closely with your facility team to plan around shipping schedules and production demands.

To talk through a plan for your facility, request a free inspection.
